恒大室内装饰施工工艺和质量标准
目录
第一章 住宅卧室装修工序间歇及工艺间歇标准······························3
1.1墙面各工序间歇及工艺间歇要求标准··································· ········3
1.2地面各工序间歇及工艺间歇要求标准············································3
1.3木地板施工基层要求标准································································4
1.4细部处理各工艺间歇要求标准························································4
1.5其它装修施工要求············································································4
第二章 住宅卧室装修工艺流程标准·····················································5
第三章 住宅卧室装修施工工艺和质量标准····························· ···········6
3.1场地移交····························································································6
3.2弹线···································································································10
3.3电线穿管····················· ······································································14
3.4卧室地面找平···················································································15
3.5墙面砖砌筑·······················································································17
3.6墙面涂料施工···················································································23
3.7天花射灯、石膏线安装·····································································28
3.8入户门安装·······················································································31
3.9地面砖、石材铺贴·············································································34
3.10窗台石铺贴·····················································································40
3.11天花吊顶扇灰、涂饰乳胶漆···························································42
3.12墙面造型绘制、安装·······································································47
3.13橱柜、卫浴安装················································································51
3.14户内门安装······················································································57
3.15木地板安装······················································································63
3.16墙面玻璃镜面安装·········································································70
3.17墙面木墙裙造型油漆·····································································70
3.18墙纸贴铺·························································································73
3.19阳台护栏安装·················································································77
3.20低窗护栏安装·················································································78
3.21墙面软包制作安装·········································································80
3.22灯具、插座插头面板加装·······························································82
3.23卫生洁具安装·················································································97
3.24卫浴五金安装···············································································104
3.25淋浴隔断安装···············································································105
3.26细部处理·······················································································106
3.27石材镜面处理···············································································114
3.28卫生清理·······················································································116
恒大地产集团
住宅室内装修施工工艺和质量标准
施工工序原则:先里后上、先湿后干、先内后外、先粗后细、先制作后安装。
第一章 住宅卧室装修工序间歇及工艺间歇标准
1.1墙面各工序间歇及工艺间歇要求标准
≥28天 ≥28天 ≥15-20天 ≥7天
工艺要求 工艺要求 工艺要求
1.2地面各工序间歇及工艺间歇要求标准
1、卧室木地板、地毯等基层地面找平完成后,可下人作业间歇时间为不超过48小时。
2、客厅、餐厅、厨房、卫生间、阳台、电梯竖井、首层大堂等地面砖、石材铺贴完成后装修公司,可下人作业间歇时间为不超过48小时。
3、室内地坪砖、石材及地面找平完成后,墙面1米线以下地面刮装饰腻子应该间歇不大于15-20天,其规定含水率不小于14﹪。
1.3木地板施工基层要求标准
木地板地面基层含水率标准一览表
地区
季节
南
北
春、夏
≤12﹪
≤8﹪
秋、冬
≤8﹪
≤8﹪
1.4细部处理各工艺间歇要求标准
1、厨房、卫生间、阳台、电梯竖井、首层大堂等墙面砖采用湿贴工艺,砖缝砂浆清理所需间歇时间为3-6小时。
2、墙面、地面、台面等湿贴作业完成后,需钻孔、打眼等间断时间不超过14天。
3、各交界面细部处理打胶后,与卫生清理间歇时间不超过24小时。
4、入户门窗框安装后,门扇安装所需间歇时间不超过72小时;户外门窗框安装后,门扇安装所需间歇时间不超过24小时。
1.5其它装修施工要求
1、小高层结构到8层,中中层、高层结构施工到12层,砌体开始回填时,装修施工单位定标、不超过2名装修管理人员到位。
3、外立面装饰完成10层,外脚手架拆除旁边5层,且卫生打扫完毕,进行场地移交,装修施工工人全部到位。
4、小高层分2批移交,每批5层室内装修施工工艺,移交间歇时间15天;中高层、高层分3批移交,第1批5层,第2、3批移交10层左右,流水施工作业。
第三章 住宅卧室装修施工工艺和质量标准
3.1场地移交
3.1.1室内场地移交
1、室内构造墙壁、墙面无穿透性裂缝和破损水隐患。
2、室内天花结构板无下挠,平整度误差不小于8mm,梁底两端高差不小于8mm,模板接缝处应磨平。
3、墙体屋面、批荡(卫生间、厨房地板为1:2水泥沙浆,其余墙体为混合砂浆)完成,基层无裂缝、开裂、起灰等品质缺失,房间墙壁阳角部位需做不超过2米高1:2水泥沙浆护角,垂直度、平整度误差不小于3mm。
4、铝合金门、窗框安装到位,窗台两端长度偏差不小于10mm,阴阳角方正偏差不小于4mm,窗框塞缝完毕且淋水试验合格,无窗框渗漏水。
5、厨房、卫生间、阳台等给排水管线敷设及给水管试压合格。
6、厨房排烟安装并挂网批荡,挂网与地面敷设150mm,防水封堵和出水口安装完工且验收合格,烟道排烟口顶至屋架底宽度为150mm。

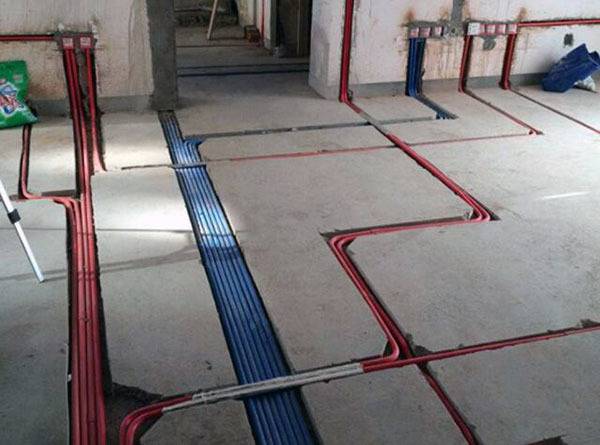

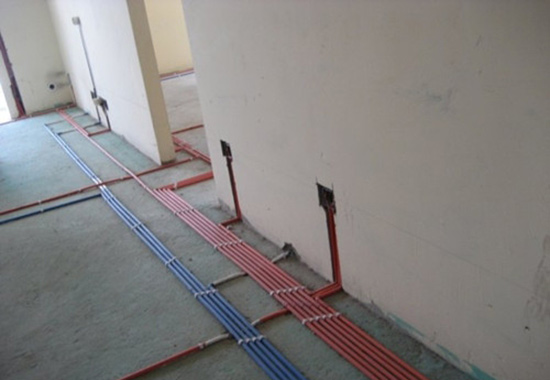

7、强弱电配管管线、底盒位置与设计图纸一致,管线畅通。
8、隐蔽水电管线位置要标识清楚。
9、高位空调(卧室、书房)套管穿高于或等于700mm高的窗顶梁时,套管孔顶距梁底不小于220mm;穿剪力墙或砌体时管道孔顶距板底不超过400mm,且不小于600mm。
10、地面坡度误差调节在±10mm内,平整度偏差不小于8mm,阳
台污水立管封堵和排水试验完成,无渗漏水。
11、阳台防水铺装完毕且验收合格。
12、户外门洞宽度满足设计要求装修,门套两侧及上面楼板砌筑材料严禁为实心铸件,且长度精度不小于10mm。
13、北方地区地暖管施工、保护完毕。
14、卫生间沉箱回填施工完工,给排水管口预埋定位准确。
15、飘窗铝合金边框与地面收口需凹入墙体10-20mm。
16、室内各厨房层高、进深尺寸误差不小于10mm,对角线尺寸误差不小于15mm,地面清洗干净。
17、墙面需要弹出结构1米线基准点且定位精准。
18、外墙施工完成且脚手架拆除完毕。
19、每栋楼大概每五层需各有一处满足装饰施工选用的水源、电源接入口。
3.1.2电梯前室
1、结构屋面无穿透性裂缝和开裂水隐患。
2、天花结构屋面平整度误差不小于8mm。
3、墙体屋面、批荡(1:2水泥砂浆)完成,基层无空鼓、起灰等品质缺失,垂直度、平整度误差不小于3mm。
4、入户门框、管井门框、防火门扇、铝合金窗框、风口百页框、电梯门板、消防箱等调试到位,管井门框、消防箱高出地面基层(含保温层)23mm(以墙砖结合层为10mm厚计算)。
5、电梯召唤箱底盒预留洞口定位精确。
6、地面坡度误差调节在±10mm内室内装修施工工艺,平整度偏差不小于8mm,地面管道支墩完成,试压后无破损,管井土建封堵完成,无渗漏水。
7、电梯前室方正,开间、进深尺寸误差不小于10mm,对角线尺寸误差不小于15mm。
8、墙面需要弹出结构1米线基准点且定位精准。
9、地面清洗干净。
3.1.3首层大堂
1、天花板预留洞口封堵完毕且无破损水,消防管、强弱电、热力管主管等安装完成。
2、墙体屋面、水泥沙浆(1:2)批荡完成,无接缝、起灰等品质缺失,垂直度、平整度不小于3mm。
3、首层入户门框、管井门框、防火门扇、电梯门板等加装到位。
4、地面坡度误差调节在±10mm内,平整度偏差不小于8mm,地面水、电、暖管预埋完成,试压后无渗漏。
5、首层大厅层高、进深尺寸误差不小于10mm,对角线偏差不小于15mm。
6、墙面需要弹出结构1米线基准点且定位精准。
7、地面清洗干净。
8、入户大厅上层露台防水处理,蓄水无漏水。
3.2弹线
3.2.1地面标高定位线
1、弹出结构1米线。
2、确定地面完成面标高定位线,无地暖地区一般以结构1米线上935mm为±0.000;北方地暖地区一般以结构1米线上880mm为±0.000。
3、根据设计图纸上标相对标高,定各空间地面相对标高。
